Agile 2.0 Release Dashboard
Summarize
Summary of Agile 2.0 Release Dashboard
The Agile 2.0 Release Dashboard, accessible via All > Agile Development > Dashboards, is designed to help ServiceNow customers track and analyze the progress of stories within a current release. It provides real-time visibility into story completion, scope changes, team pace, and forecasts for release completion. The dashboard excludes canceled stories from its metrics to ensure accuracy.
Show less
Key Features
- Release Summary Tab: Displays percentage of work completed, elapsed time, number of stories missing estimates, current status of stories, scope changes, and progress trends.
- Cycle Time Tab: Visualizes the time stories take to move from in-progress to complete, highlighting outliers and bottlenecks.
- Widgets and Indicators:
- Percent Completed: Shows story points completed versus total planned work, helping assess if the team is on schedule.
- Scope: Indicates total planned story points for the release and allows drill-down into story details.
- Time Elapsed: Displays the percentage of time used between release start and planned end dates.
- Blocked Work: Highlights stories missing estimates, which is critical for ensuring meaningful dashboard insights. Entering a default "1" for story points can keep the dashboard functional if estimates are not used.
- Data Visualizations: Includes Release Burnup, Release Burndown, Release Cumulative Flow Diagram, and Story Cycle Time charts. These visualizations help analyze work completion trends, scope changes, progress between story states, and story cycle durations.
- Forecasting: Burnup and burndown charts include forecast series predicting scope changes and completion likelihood based on historical data, alerting teams if scope growth outpaces completion.
- Customization: Dashboards and reports can be customized to suit specific team needs and preferences.
- Upgrade Note: Customers upgrading from earlier versions should reinstall the dashboard from the Solution Library to access the latest layout and visualizations.
End User Roles and Benefits
Product Owners with the scrumuser role benefit from this dashboard by gaining insight into scope changes, team velocity, and real-time story progress. It enables them to track planned stories, resolve bottlenecks, and identify stories that take longer than expected, helping ensure timely release delivery.
Practical Application for ServiceNow Customers
- Use the dashboard to monitor ongoing release progress and adjust plans based on real-time data.
- Identify and address scope changes early to avoid release delays.
- Leverage cycle time analysis to pinpoint bottlenecks or inefficient story states.
- Ensure all stories have estimates to maximize the accuracy and usefulness of metrics and forecasts.
- Customize reports and visualizations to align with your team’s workflow and reporting requirements.
Track the progress of your stories and analyze scope changes in the current release using Agile 2.0 Release Dashboard.

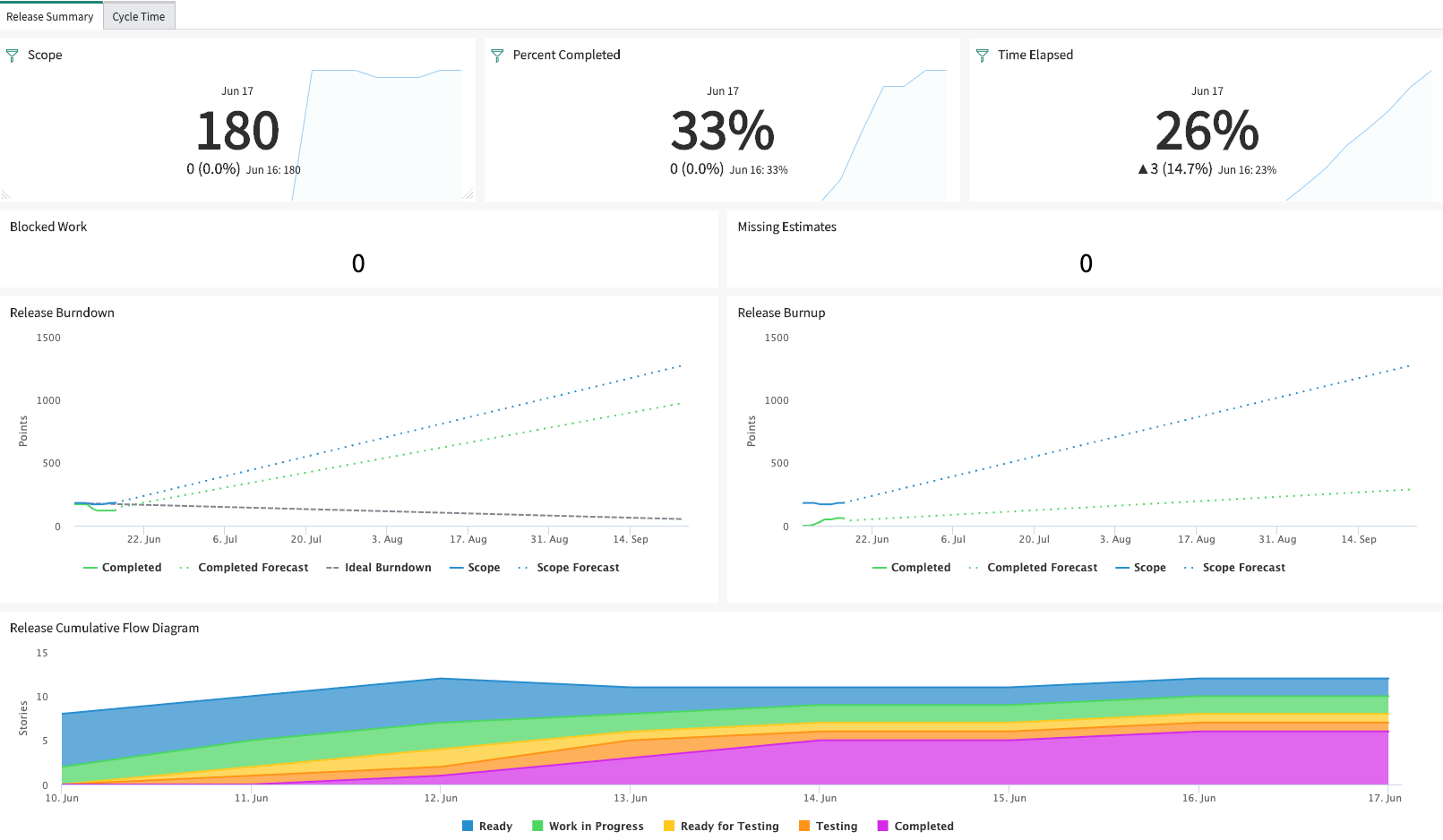

Navigate to and select Agile 2.0 Release Dashboard.
- Displays important details of the release such as percentage of work that is complete, time elapsed, and total number of stories that are missing estimates.
- Displays the number of stories of the release in their current state and their progress.
- Indicates the scope changes, if any, and trends of those scope changes.
- Indicates the pace at which the team is completing stories that are planned for the release.
- Forecasts data showing the likelihood of completing the release as planned.
- Shows time elapsed for the stories of a release to go from an in-progress state to a completed state.
End user and roles
| End user and goal | Required role | Benefits |
|---|---|---|
Product owner: Needs visibility into scope changes, team's pace, and real-time progress of the stories for the release. |
scrum_user |
|
Indicators
- Scrum: Sum of story points of completed stories in the active releases
Generates the Completed series in the Release Burndown and Burnup reports. These series indicate the amount of work in story points that has been completed for the release.
- Scrum: Sum of story points of active stories in the current releases
Generates the scope series in the Release Burndown and Release Burnup reports. The scope series indicates the amount of work in story points that is planned for the release.
- Scrum: Time elapsed in the release
Calculates the time to be displayed in the Time Elapsed widget.
- Scrum: Count of all stories in the current release
Generates the area series in the Release Cumulative Flow Diagram report, which indicates the number of stories of the current release by state.
Breakdowns
- Scrum: Release
- Scrum: State
Widgets
- Percent Completed
Indicates the percentage of work (in story points) that has been completed in the release. This widget lets you see at a glance how much work has been completed in the release. Together with the adjacent Time Elapsed widget, these widgets let you easily see whether you are completing work at a rate consistent with achieving the release goal on schedule.
- Scope
Indicates the amount of work in story points that is planned for the release. This widget lets you see at a glance how much work must be completed to achieve the releaser goal. It also lets you drill down to detail on the stories planned into the release.
- Time Elapsed
Indicates the percentage of time that has elapsed between the start date and planned end date of the release. Together with the adjacent Percent Completed widget, these widgets let you easily see whether you are completing work at a rate consistent with achieving the Release goal on schedule.
- Blocked Work
- Indicates the total number of stories in the release that are missing estimates. It is required that you use estimates for the other indicators, widgets, and reports on this dashboard to be meaningful.Note:If you do not estimate stories, enter a "1" in the Story Points field. The other indicators, widgets, and reports will then effectively function by count.
- Blocked Work
Indicates the number of stories in the release that are missing estimates.
Data visualizations
- Release Cumulative Flow Diagram
- Story Cycle Time
| Title | Type | Description |
|---|---|---|
Release Burnup |
Line chart |
Analyse the burnup trends, and estimate when the release work is likely to be completed. The release burnup report comprises the following series that can be hidden or displayed based on your preference:
Note: The point at which the Completed Forecast series intersects with or crosses the Scope
Forecast series is a predictor for when the release might be completed. If the Completed
Forecast series and the Scope Forecast series do not appear to ever intersect, it is a
warning that scope is being added faster than work is being completed. |
Release Burndown |
Line chart |
Indicates the scope changes, if any, and trends of those scope changes. Indicates the ideal pace of work, how much work is remaining, and if the scope likely to be completed before the end of the sprint. The Release Burndown report comprises the following series that can be hidden or displayed based on your preference:
|
Release Cumulative Flow Diagram |
Area chart |
Monitor the progress of all the stories of your release between its actual start and end dates. View the number of stories in each state by their arrival to a state, time in this state, and its departure from this state. The Release Cumulative Flow Diagram report comprises the
following areas that can be hidden or displayed based on your preference:
Note: Stories in Ready and Cancelled states are not included in this report. |
| Title | Type | Description |
|---|---|---|

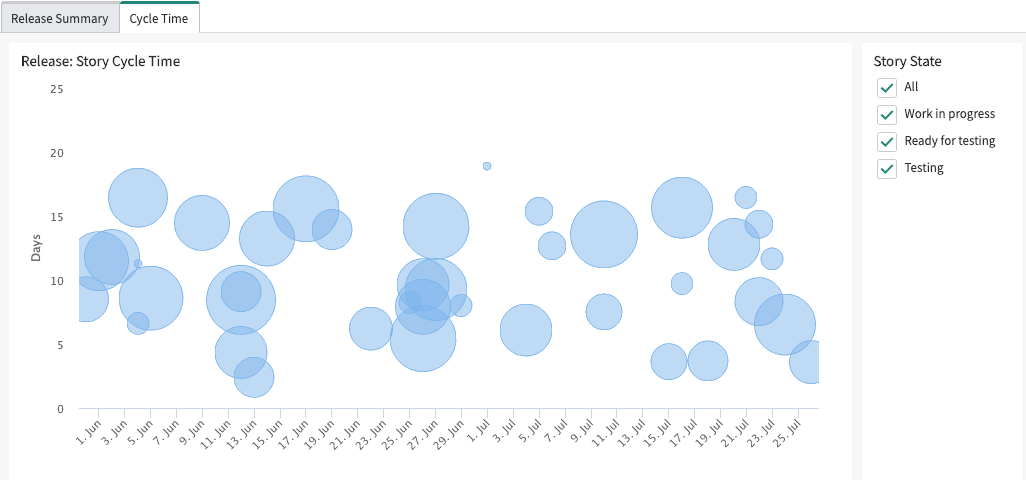

| Story Cycle Time | Bubble chart |
Identify the time taken for each story in the release to move from an in-progress state to completion. Each bubble on the graph represents a story. The height of the bubble from the x-axis shows how long that story took to move from an in-progress state to completion. The size of the story bubbles are relative to each other based on their story points. Hovering your mouse cursor over a bubble displays the following details about that story:
From the Story State section towards the right of the report, you can filter the report to view the cycle time of the stories for the selected states. The chart displays the cycle time for each story as the cumulative sum of all duration of the selected states. If there are too many stories at any area of the chart and the bubbles appear crowded on the report, you can zoom in that particular area of the report for a clearer view. |
You can customize the Burnup, Burndown, and Cumulative Flow Diagram reports. For more information, see Customizing Agile 2.0 dashboard reports.
