Holiday schedules in a release
Summarize
Summary of Holiday schedules in a release
This guide explains how to associate a holiday schedule with a release in ServiceNow to ensure accurate phase and release durations by considering non-working days like holidays and weekends. It illustrates the adjustment of timelines based on a holiday schedule, specifically for a release targeting a readiness date of September 5, 2025, with a total of 60 working days across four phases: Planning, Development, Testing, and Implementation.
Show less
Key Features
- Adjustment for Non-working Days: The system adjusts start and end dates of each phase to account for holidays and weekends while keeping phase durations intact.
- Fixed Phase Durations: Each phase's duration remains fixed in working days, but the overall calendar span may extend due to non-working days.
- Working Day Calculations: Original and adjusted dates are determined by counting calendar days, with adjustments made to align with the nearest working day as needed.
Key Outcomes
ServiceNow customers can expect:
- A clear understanding of how holiday schedules impact release timelines, allowing for better planning and resource allocation.
- Increased accuracy in project timelines, minimizing the risk of missed deadlines due to overlooked non-working days.
- Enhanced visibility into the overall release duration, which extends to 87 calendar days while maintaining 60 working days across all phases.
You can associate a holiday schedule with a release so that the phase and release durations are calculated considering non-working days.
The following example of a release shows how holiday schedules affect its overall timeline to keep important dates on working days.
Let's say a release has 4 phases: Planning, Development, Testing, and Implementation, with durations of 10, 25, 15, and 10 days, respectively, totaling 60 working days. The release readiness target date is set to Sep 5, 2025, and has a public and weekend holiday schedule (U.S. Federal + Weekend holidays in 2025) associated. So, the start and end dates of each phase are adjusted to account for non-working days (holidays and weekends on the schedule), to keep the phase durations intact. Key dates also follow the same adjustment rule.
- Considerations:
-
- Total release duration: 60 working days
- Phases and durations: Planning: 10 days; Development: 25 days; Testing: 15 days; Implementation: 10 days
- Release readiness target date: Sep 5, 2025
- Working days in a week: Mon through Fri (5 days)
- Non-working days on the associated schedule:
- Weekends are non-working days so skipped.
- Federal holidays in 2025, relevant to the release period are as follows:
- Jun 19: Juneteenth (Thu).
- Jul 4: Independence Day (Fri).
- Sep 1: Labour Day (Mon).
- Adjustment rules:
- The original end date of the last phase is the release readiness target date, usually a working day so no adjustment needed. For all phases before the last, original start and end dates are derived by counting consecutive calendar days, regardless of whether they fall on working or non-working days. Their adjusted end and start dates are the actual dates on a working day, skipping non-working days.
- The original start date is determined by counting all calendar days backward from the adjusted end date. The adjusted start date is the actual start date on a working day, skipping non-working days.
- If a key date or the phase start or end date falls on a holiday or weekend, shift to the previous working day.
- The duration of each phase (in days) remains fixed, but holidays and weekends within the phase period extend the calendar span.
With these considerations, let's calculate the working days in the release timeline and adjust the phase and release duration accordingly.
- Calculation of release dates with holiday adjustments
-
Table 1. Phase 4: Implementation Option Description Phase Phase 4: Implementation Original end date Sep 5 (Fri) (Same as the release readiness target date)
Adjusted end date Sep 5 (Fri) (A working day, no adjustment needed)
Original start date Aug 27 (Wed) (10 days counted backward from the phase's adjusted end date, includes weekends and holidays)
Adjusted start date Aug 22 (Fri) (excludes weekends and holidays, see the End date calculation)
Key dates Deployment preparation: On fifth day from the phase's adjusted start – Aug 28 (Thu) (Excludes weekends and holidays. Falls on a working day, no adjustment needed)
Original duration 10 days Aug 27 (Wed) – Sep 5 (Fri)
Adjusted duration 15 calendar days (10 working days + 5 non-working days) Aug 22 (Fri) – Sep 5 (Fri)
End date calculation Working days: 10 - Sep 5–2 (Fri-Tue): 4 days.
- Aug 29–25 (Fri-Mon): 5 days (total 9 days).
- Aug 22 (Fri): 1 day (total 10 days).
Non-working days: 5- 1 holiday skipped: Sep 1 (Labor day)
- 2 weekends skipped: Aug 30-31; Aug 23-24
Table 2. Phase 3: Testing Option Description Phase Phase 3: Testing Original end date Aug 21 (Thu) (The day before the Phase 4 start date)
Adjusted end date Aug 21 (Thu) (A working day, no adjustment needed)
Original start date Aug 7 (Thu) (15 days counted backward from the phase's adjusted end date, includes weekends and holidays)
Adjusted start date Aug 1 (Fri) (Excludes weekends and holidays, see the End date calculation)
Key dates Test plan approval: On fifth day from the phase's adjusted start – Aug 7 (Tue) (Excludes weekends and holidays. A working day, no adjustment needed)
Original duration 15 days Aug 7 (Thu) – Aug 21 (Thu)
Adjusted duration 21 calendar days (15 working days + 6 non-working days) Aug 1 (Fri) – Aug 21 (Thu)
End date calculation Working days: 20 - Aug 21-18 (Thu-Mon): 4 days.
- Aug 15–11 (Fri-Mon): 5 days (total 9 days).
- Aug 8-Aug 4 (Fri-Mon): 5 days (total 14 days).
- Aug 1 (Fri): 1 day (total 15 days).
Non-working days: 6- 0 holiday skipped
- 3 weekends skipped: Aug 16–17; Aug 9–10; Aug 2–3
Table 3. Phase 2: Development Option Description Phase Phase 2: Development Original end date Jul 31 (Thu) (The day before the Phase 3 start date)
Adjusted end date Jul 31 (Thu) (a working day, no adjustment needed.)
Original start date Jul 7 (Mon) (25 days from the phase's adjusted end date, includes weekends and holidays)
Adjusted start date Jun 26 (Thu) (excludes weekends and holidays, see the End date calculation)
Key dates Sprint end: Every 10 working days from the phase's adjusted start – Jul 10 (Thu), Jul 24 (Thu) (all working days, no adjustment needed)
Original duration 25 days Jul 7 (Mon) – Jul 31 (Thu)
Adjusted duration 36 days (25 working days + 11 non-working days) Jun 26 (Thu) – Jul 31 (Thu)
End date calculation Working days: 25 - Jul 31-28 (Thu-Mon): 4 days.
- Jul 25–21 (Fri-Mon): 5 days (total 9 days).
- Jul 18–14 (Fri-Mon): 5 days (total 14 days).
- Jul 11-7 (Fri-Mon): 5 days (total 19 days).
- Jul 3-Jun 30 (Fri-Mon): 4 days (total 23 days).
- Jun 27-26 (Fri-Thu): 2 days (total 25 days).
Non-working days: 11- 1 holiday skipped: Jul 4 (Independence Day)
- 5 weekends skipped: Jul 26-27; Jul 19-20; Jul 12-13; Jul 5-6; Jun 28-29
Table 4. Phase 1: Planning Option Description Phase Phase 1: Planning Original end date Jun 25 (Wed) (The day before the Phase 2 start date)
Adjusted end date Jun 25 (Wed) (a working day, no adjustment needed)
Original start date Jun 16 (Mon) (10 days from the phase's adjusted end date, includes weekends and holidays)
Adjusted start date Jun 11 (Wed) (excludes weekends and holidays, see the End date calculation)
Key dates Midpoint: On fifth working day from the phase's adjusted start – Jun 17 (Tue) (a working day, no adjustment needed)
Original duration 10 days Jun 16 (Wed) – Jun 25 (Wed)
Adjusted duration 15 days (10 working days + 5 non-working days) Jun 11 (Wed) – Jun 25 (Wed)
End date calculation Working days: 10 - Jun 25–23 (Wed–Mon): 3 days.
- Jun 20 (Fri): 1 day (total 4 days).
- Jun 18–16 (Wed-Mon): 3 days (total 7 days).
- Jun 13–11 (Fri-Wed): 3 days (total 10 days).
Non-working days: 5- 1 holiday skipped: Jun 19 (Juneteenth)
- 2 weekends skipped: Jun 21-22; Jun 14-15

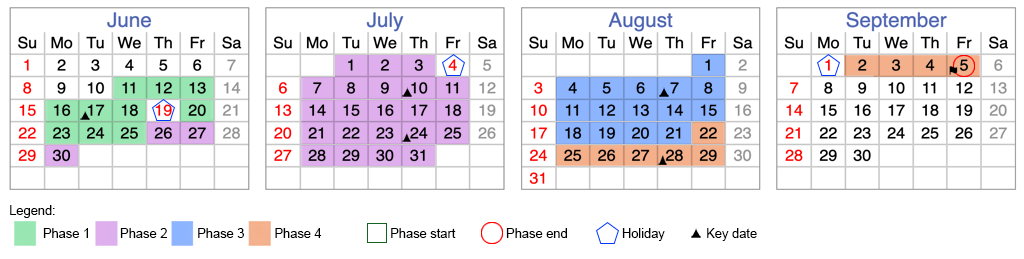

- Summary Timeline
-

The timeline extends beyond the 70-days original duration to account for weekends and associated holiday schedule, but the phase durations remain fixed in working days.
Table 5. Summary of release timeline Option Description Original calendar span Jul 8 to Sep 5 Adjusted span, excluding non-working days Jun 11 to Sep 5 Original release duration 60 working days Adjusted release duration 87 calendar days Non-Working Days 87 – 60 = 27 days (12 weekends + 3 holidays)
