Change Premium dashboard

  • Release version: Washingtondc
  • Updated February 2, 2023
  • 2 minutes to read
  • Summarize
    Summarized using AI
    This content was generated using new OpenAI-powered functionality. Results are provided on an as is basis and are not guaranteed to be accurate or complete.

    Summary of Change Premium Dashboard

    The Change Premium Dashboard in IT Service Management provides a comprehensive view of change processes using Workbench widgets and advanced analytics features. It helps Change Managers analyze trends in change request resolution to identify areas needing improvement.

    Show full answer Show less

    Key Features

    • Indicators: Key metrics include the number of open changes, average age of open changes, and the percentage of urgent changes, among others.
    • Data Visualizations: Includes various visualization types like Single Scores for active changes and grouped charts for open changes by priority and risk.
    • Breakdowns: Data can be broken down by different categories such as Age, Priority, Risk, State, Assignment Group, and Type.

    Key Outcomes

    By utilizing this dashboard, Change Managers can effectively monitor and manage change requests, ensuring timely responses and resolutions, which ultimately enhances overall change management efficiency.

    This dashboard uses Workbench widgets and other advanced Platform Analytics features to give you all the information about the Change process in one place.

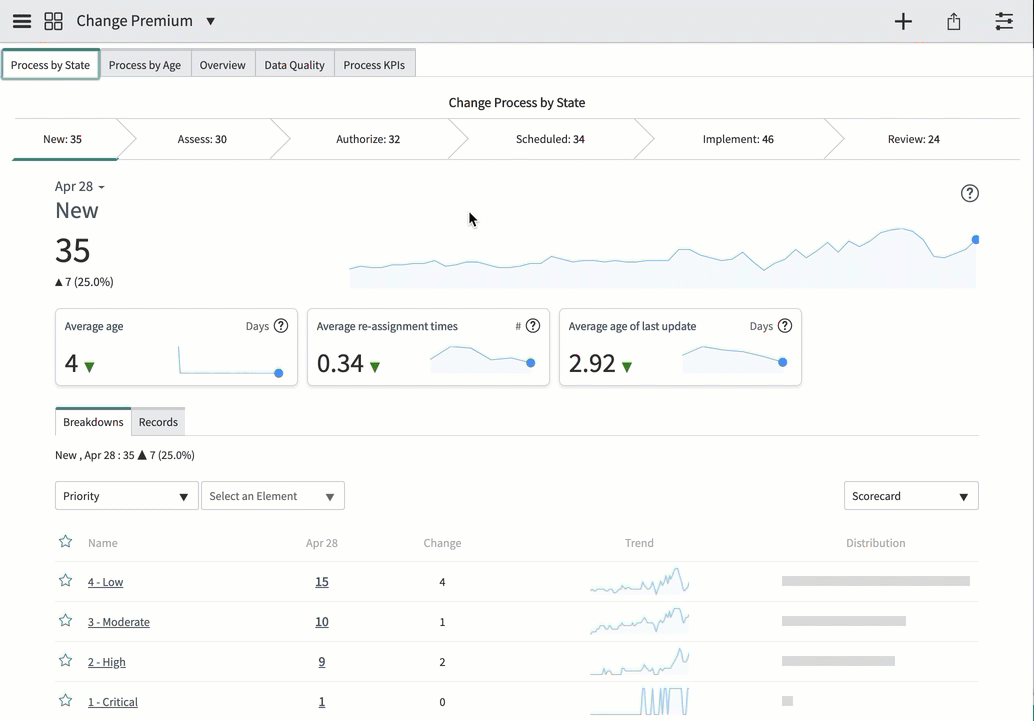

    Animated tour of the tabs of the Change Premium dashboard

    End user and roles

    End user and goal Required role
    Change Manager - Needs to break down the trends in change request resolution over time to spot areas that need attention itil

    Indicators

    Number of open changes
    The number of changes open at the end of the collection date. This calculation is the number of changes opened on or before the collection date and not closed by that date.
    Average age of open changes
    [[Summed age of open changes]] / [[Number of open changes]] / 24
    Average re-assignment of open changes
    [[Summed re-assignment of open changes]] / [[Number of open changes]]
    Average age of last update
    The average length of time since the last update made to a change.
    Number of new changes
    The number of new changes with a registration date on the data collection date.
    Change backlog growth
    The number of closed changes subtracted from the number of new changes.
    Number of closed changes
    The number of changes with a close date on the data collection date.
    % of urgent changes
    Percentage of urgent changes. Is a formula: Number of new changes classified as urgent / Number of new changes * 100
    Average close time of changes
    The average length of time in hours between when a change request is opened and closed.
    Average implementation time of closed changes
    The average length of time in hours between when a change request enters the Implementation state and when it is closed
    Number of reassigned open changes
    The number of changes with a reassignment count of 1 or higher
    Number of unsuccessful changes
    The number of closed changes with a Close Code of "Unsuccessful"
    The following indicators are not displayed on the dashboard but are used in formulas:
    • Summed age of open changes
    • Summed age of updated since of open changes
    • Summed duration of closed changes
    • Summed implementation time closed changes
    • Summed re-assignment of open changes

    Breakdowns

    • Age
    • Category
    • Priority
    • Risk
    • State
    • Assignment Group
    • Type

    Data visualizations

    Title Type Description
    Changes Opened Today Single ScoreSingle-score icon Number of active changes opened on the day the dashboard is viewed.
    Unassigned Changes Single ScoreSingle-score icon Number of active changes that don't have an assignee.
    Overdue Changes Single ScoreSingle-score icon Number of changes that are in one of the following states: New, Assess, Authorize, or Scheduled and for which the planned start date is before the current date.
    Changes On Hold Single ScoreSingle-score icon Number of changes with the status On hold.
    Conflicting Changes Single ScoreSingle-score icon Number of changes with the status Conflict.
    Rejected Changes Single ScoreSingle-score icon Number of changes for which the approval status is Rejected.
    Open Changes - Grouped Horizontal BarHorizontal bar icon Open changes grouped by Priority
    Upcoming Changes (30 days) - Grouped Horizontal BarHorizontal bar icon Active changes for which the planned start date is in the past 30 days and for which the state is Scheduled.
    Open Changes by Risk and Priority HeatmapHeatmap icon Active changes sorted by risk on the Y-axis and priority on the X-axis. Cells are highlighted from white for low scores to dark blue for high scores.
    Upcoming Changes (30 days) by Risk and Priority HeatmapHeatmap icon
    Changes Opened per Month by Type ColumnColumn report icon All closed reports opened in the current calendar year. Grouped by type and trended by month opened.
    Closed Changes per Month Line Line report icon Number of closed changes per month expressed on a line chart.
