on 11-01-2024 04:09 PM
What is the purpose of ‘planning item’ table?
SPW enables portfolio/product managers to do hybrid planning i.e., the ability to plan both waterfall (projects) and agile (epics) work together and view all the items on the same roadmap. This will help in making the necessary tradeoff decisions by considering all kinds of work in the pipeline. This will also eliminate the disconnect of planning projects and epics separately.
Project, epics, and demands are different objects. They are currently managed by customers separately in project workspace, demand management, and Agile2.0 applications. They have different fields which serve different purposes. Even if there are common fields across these three tables such as state, status, priority, etc., the values within those fields are different.

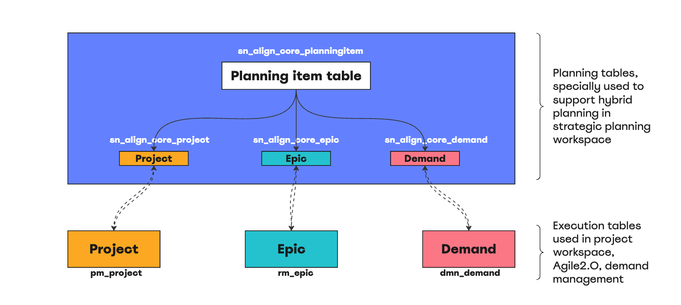

To plan these different objects in the same portfolio plan and to show them on the same roadmap, we created a new table called ‘Planning Item’ that houses all these items in one table. Only the fields that are relevant (like owner, state, status, priority, financials, etc.) for planning at portfolio level are synced into the planning item table.
What is a planning item extension?
A base planning item is extended to multiple planning item tables to contain different planning item type entities. Fields applicable to all planning item types are added into the base planning item table. Whereas the fields specific to a type are added in the respective extension of the planning item table.
Project, epic, and demand tables are internally synced with the respective extensions of the planning item table. This is a two-way sync that means, any changes done in SPW are reflected in the execution side and vice versa.
What are the different OOTB planning item types?
- The different OOTB planning items one can plan together in SPW are
- Project
- Demand
- Epic
- Product Idea
- Product idea does not have a corresponding execution table. This is a new table created in SPW to help product managers manage their product backlog.
What are custom planning item types?
- Sometimes in customer environments there is a need to plan items other than the OOTB planning item types. Ex: enhancement, themes, capabilities, etc.
- To help customers plan their own items, we allow customers to create a new custom planning type by extending the planning item table.
- OOTB, we provide five free custom planning item tables. These can be easily renamed and configured and synced with customer’s own tables that need to be included for planning. In addition to this, customers can create new custom planning types by utilizing the free additional tables quota that comes with SPM Pro license.
- 5,268 Views
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
Thanks for this @Sandeep V1
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
How do we add new Planning Items so they are slush bucket options for a new lens? For example, I want to add Initiatives from the [sn_align_core_initiative] table.
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
Hello @Sandeep V1 could you please advise on how to handle the above, asked by MGanon?
Thank you
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
Hi @Sandeep V1 ,
I have requirement where customer want create a free text field in portfolio plan where they portfolio manager can use it to group similar items. i have created one field in planning item table and it is visible in workspace but I am not able to configure group by option for that field in prioritization section or any other section of planning, can you please help.
Thanks,
Shreyas
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
Please explain, when I create a demand and create a resource assignment, why isn't the Planning Item automatically updated similar to the way the demand was populated into a resource plan?
What do I have to do to include a demand in the planning item table?
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
I think what's missing from the 'why' explanation is recognition that, until the APW/SPW arrived, and planning items were made available, the only way to see a Project and a Demand side-by-side and evaluate them as equals was by adding them to a Program or Portfolio.
What's really transformative about the Planning Item service in the SPW is not just that it remains in synch automatically, but that it allows you to:
- bring in any type of planned work (CWM initiatives, Epics, Continuous Improvement activities, etc)
- make an evaluation about which ones provide the best value to the organization in alignment with your strategic objectives
- work out which ones are possible both financially and in light of your resource profile
- track delivery and visualize progress
It's a fantastic system.
- Mark as Read
- Mark as New
- Bookmark
- Permalink
- Report Inappropriate Content
May I know why you want to add initiative? OOTB, we restricted that to be added to the lowest level of the lens as we have a strategic investments lens in which initiative is one of the entities and is at a higher level. We also allow you to create and plan a portfolio for initiatives. So I want to undestand why you want to view initiatives along with projects and demands, at the same level. Aren't your initiatives higher than the projects and demands?
