Changing Project Import Fields

drewgordan
Kilo Contributor

How can I change the import from MSP into SN to look at the Resource Initials field instead of the Resource Name field?   I have mapped the Resource Initials in MSP to mirror the user names in SN and need to change the import map/process.

13 REPLIES 13

Using the Project Import & Export guide on Docs.  In particular, this body of text:

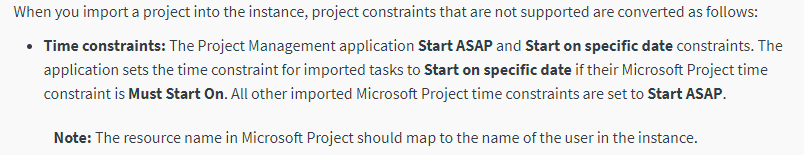

"When you import a project into the instance, project constraints that are not supported are converted as follows:

  • Time constraints: The Project Management application Start ASAP and Start on specific date constraints. The application sets the time constraint for imported tasks to Start on specific date if their Microsoft Project time constraint is Must Start On. All other imported Microsoft Project time constraints are set to Start ASAP."

What's not said is that all Projects imported to Kingston are now forced to Manual calculation.  What calculation expressly prohibits Start ASAP constraints?  Manual projects.

So, you import a project which defaults to Manual, which drops all the Start ASAP time constraints.  Customer looks at the size of the project and says "no way I'm doing that manual", swaps it to Automatic, and the schedule gets nuked from orbit.

I know that's different from previous versions because there's threads complaining about the opposite problem in previous versions (projects defaulting to auto).

See also:  INT3782352

ITSMgal
ServiceNow Employee
ServiceNow Employee

Hi - Here is the current list of imported fields and their mapping:

During an import, values from Microsoft Project overwrite fields in project records.



This is documented in docs.service-now.com



https://docs.servicenow.com/bundle/kingston-it-business-management/page/product/project-management/r...

Project Field Mapping
Microsoft Project fieldsProject Management fields
Task NameShort description
NoteDescription
StartPlanned start date
FinishPlanned end date
DurationPlanned duration
Actual StartActual start date
Actual FinishActual end date
Actual DurationActual duration
% CompletePercent complete (personalize the form to add this field)
Predecessor LagLag time between predecessor and successor
WBSWBS
CriticalCritical path
RollupRollup
Text10 (Field used for syncing purposes)Task Sys_Id
Project Header TitleProject name
Project Header Subject (Field used for syncing purposes)Top Task Sys_Id
ResourceAssigned to [assigned_to]
Note: During import, if there are multiple resources assigned to a task in Microsoft Project:
  • The first resource is added to the Assigned to field.
  • The rest of the resources are added to the Additional assignee list field.
Resource GroupAssignment Group

Hi,



Could you please tell me any update on mapping the custom fields while importing MPP file in projects.





Many Thanks,

Sanjeeva Nagendra

Andrew Bettcher
Kilo Sage

Any update on this? I'm on London.
