Cost Benefit Analysis in ITBM
- Mark as New
- Bookmark
- Subscribe
- Mute
- Subscribe to RSS Feed
- Permalink
- Report Inappropriate Content
10-16-2018 01:00 AM
Hello,
We would like to be able to perform cost benefit analysis of a project in ServiceNow. The challenge we're facing, is the following:
When costs are planned for the project CBA part, operations costs are also included for a few years after the project end - however these costs are not part of the project budget, and shouldn't be calculated in the total project cost (they are also not considered part of the project, but the operations afterwards)
We can't find an easy way to exclude the cost plans related to operations costs, as out of the box they are automatically rolled up on project level, and we don't need that. We also wouldn't like to change the behavior of the OOB total project cost field.
Until now we were discussing some options for a workaround - for example to have a demand related to the project, and calculate the CBA there so that the project total cost stays only calculated from the project cost plans, but this will make it harder for the users, as they are creating schedules to be able to identify all the costs, and we can't have schedules in the demand record.
Hoping to find another suggestion.
Thanks for the help
- Labels:
-
Project Portfolio Management

- Mark as New
- Bookmark
- Subscribe
- Mute
- Subscribe to RSS Feed
- Permalink
- Report Inappropriate Content
10-16-2018 01:39 AM
HI juliapetrova

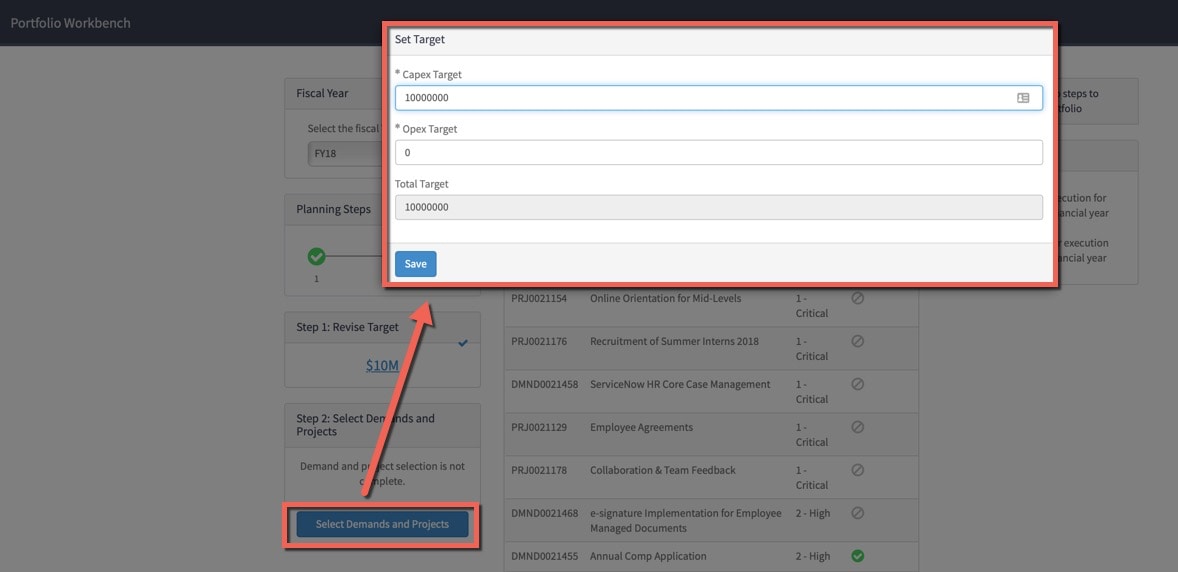

In London you are able to see Total, OPEX and CAPEX cost for a project when you create project costplan. (Detail view for Project)
When you set the targets and budgets you are able to both OPEX and CAPEX (Portfolio Workbench)
When you want to select demands and projects for execution, you are able to look at the targets as Total, OPEX or CAPEX (Portfolio Workbench)
I do believe that the funding for OPEX and CAPEX is from two different budgets - so I hope that the above will answer your question
Brian
- Mark as New
- Bookmark
- Subscribe
- Mute
- Subscribe to RSS Feed
- Permalink
- Report Inappropriate Content
10-16-2018 02:03 AM
Hi Brian,
Yes, the two different budgets you are talking about are the one of the Portfolio, and the project funding.
The issue we are having are regarding the project total cost. In the project level, Total, Capex, and Opex are generated from Cost Plans if i'm not wrong. A project budget will have both Capex and Opex, however we have additional Opex which will be incurred after the project end. If it's included as a Cost Plan on a project level, it gets included in the Total, and we are trying to avoid this behavior as we need this additional Opex only for the CBA, but it's not part of the project budget itself.
Example:
Project for ServiceNow implementation:
1. Let's say project budget is:
- Capex 10000 - for implementation
- Opex 30000 for ServiceNow licenses for the first year
- Total project cost - 40000
2. When we do a CBA, we need to present not only the project costs, but the operational costs related to ServiceNow after the project is closed for specific period (let's say 3 years after SN is implemented and the project is closed). In our case, we have additional Opex of 90000 for the on-going operations after go-live for 3 years
We can't find a way to keep the 90000 from point 2, as they are not part of the project and shouldn't be included in the baseline. At the same time, they are needed to be able to conduct a CBA and see when actually we'll have a ROI from the implementation.

- Mark as New
- Bookmark
- Subscribe
- Mute
- Subscribe to RSS Feed
- Permalink
- Report Inappropriate Content
10-16-2018 05:59 AM
Hi Juliapetrova,

- Mark as New
- Bookmark
- Subscribe
- Mute
- Subscribe to RSS Feed
- Permalink
- Report Inappropriate Content
10-22-2018 03:36 AM
Hi Juliapetrova,
Did you find a solution or do you need more feedback?
Brian
