Perform verification steps to ensure that the conversion of a team to an assignment
group is successful.
Before you begin
Role required: admin
About this task
Important: Agile Development 1.0 and its features such as Sprint burndown chart and release burndown chart are deprecated and no longer available.
Agile Development 2.0 provides the latest experience for supporting your Agile work methodology.
Procedure
-
Navigate to .
-
Verify that the team has been converted to an assignment group.
If group appears here, it implies that the group type is already set to Agile
Team.

-

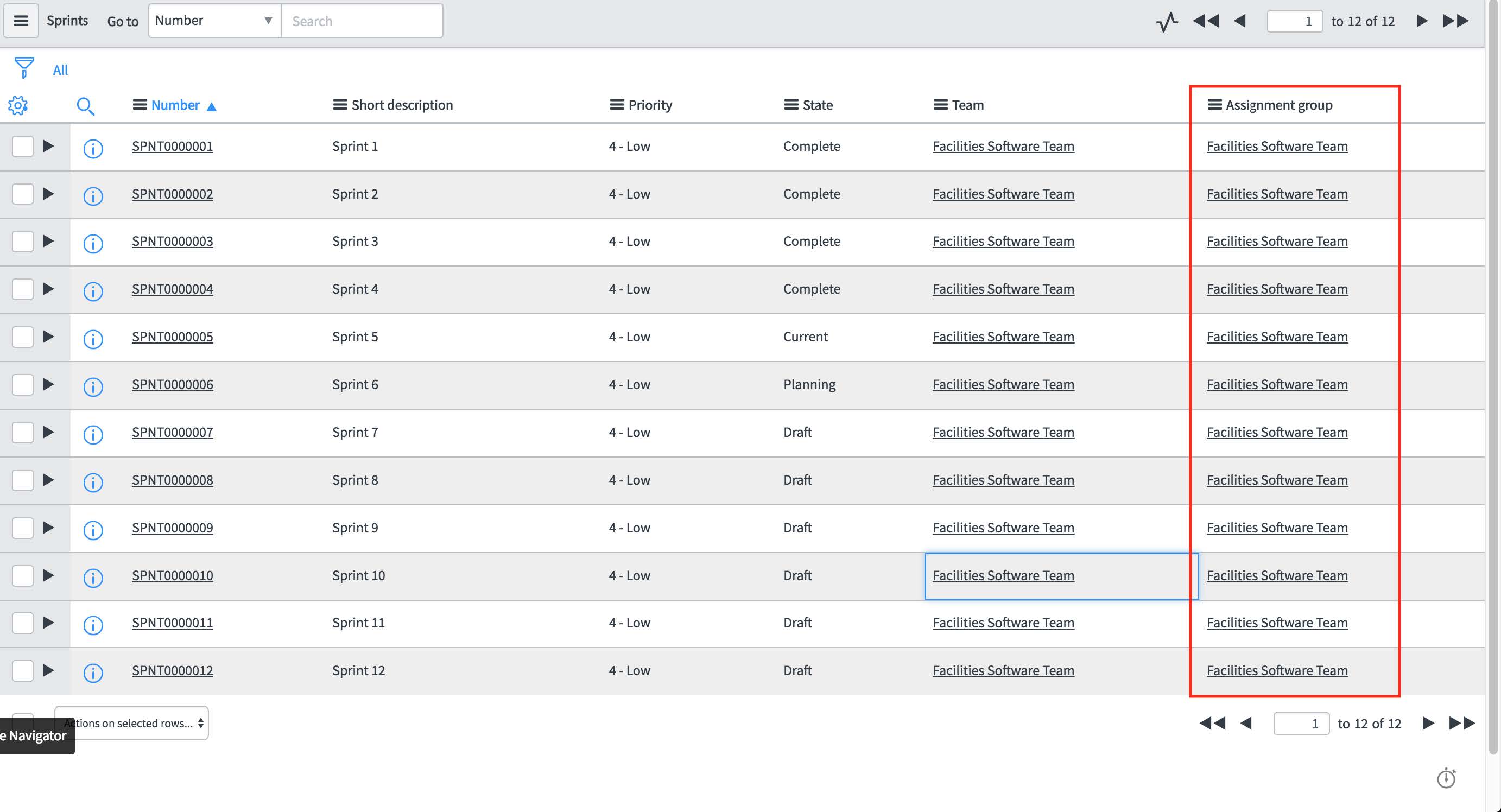

Verify that the assignment group is updated across all the sprints of the team.
It is the same sprint list that you have noted prior to conversion. This list
must have the assignment group updated after conversion.

-
Verify that the stories associated with the sprints of team have been updated
with the assignment group.
Following is the list of stories that were noted prior to converting to
group:

-
Review the
sprint burndown for the sprint that was noted prior to conversion.
It must be same as it was prior to conversion.
- Open the rm_srpint table (rm_sprint.list), or open the assignment
group.
- Click the current sprint.
- Mark any WIP story as complete.
- Review the sprint burndown that is to be updated with the completed
story.

-
Once the story is complete,
the release
burndown must also be updated correctly.

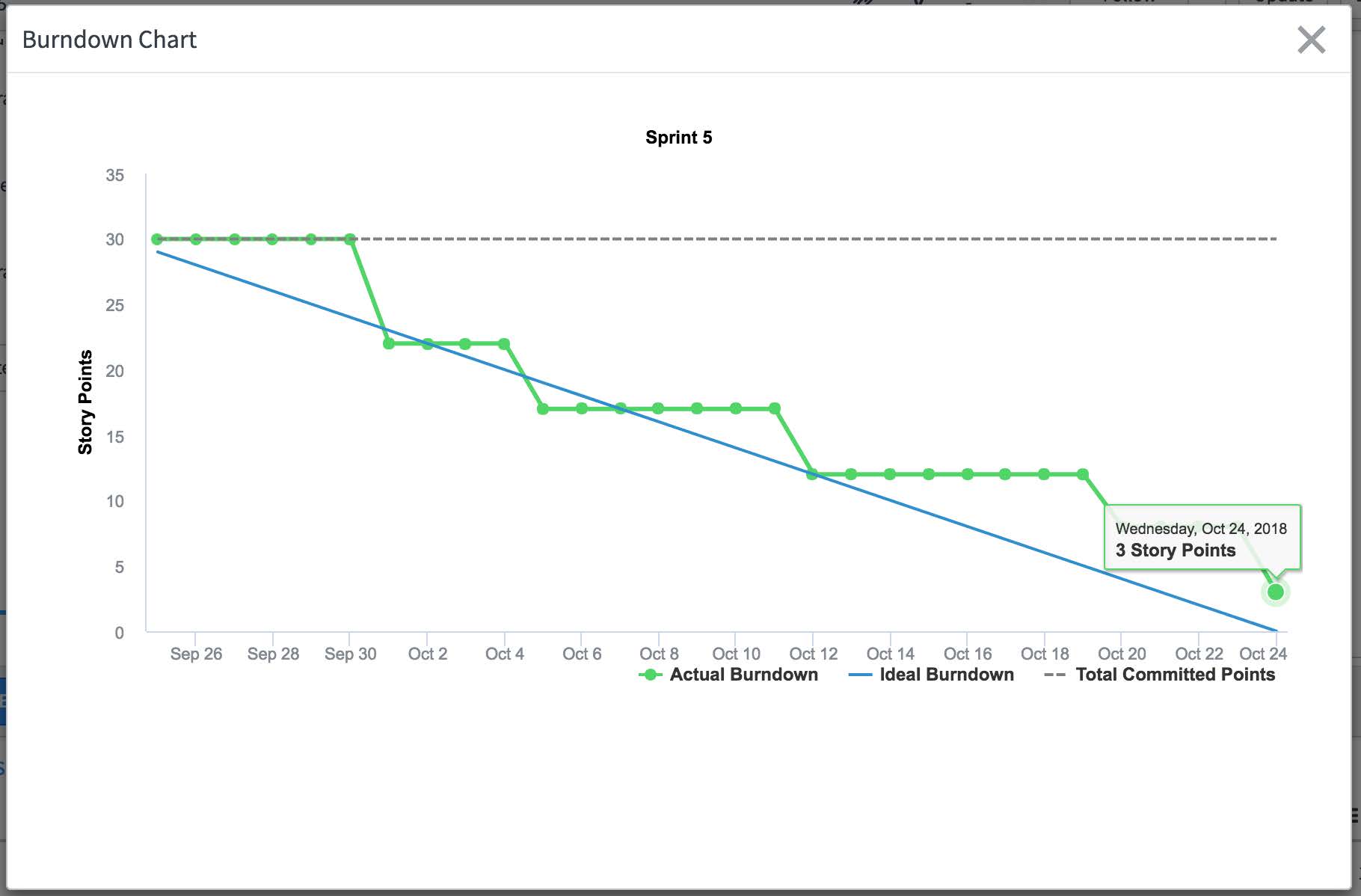

For example, in the following screenshot, the burndown is updated correctly
for the current release.

-
For Group Velocity:
-
Once you verify the steps for one group, it is confirmed that the migration has
completed successfully.
You can repeat this procedure for all other teams one by one.
This
is a synchronous process, hence, you should perform these steps on one team at a
time.
